Mastering Your California Bathroom Renovation Timeline

Embarking on a bathroom renovation is an exciting journey, promising enhanced comfort, functionality, and aesthetic appeal for your home. However, for California homeowners, the path from vision to reality often comes with unique considerations, from specific building codes to navigating a competitive market for skilled trades. Understanding a realistic California bathroom renovation timeline is paramount to setting proper expectations, managing your budget effectively, and minimizing stress.

At Powercore Inc, a dual-licensed General B & C-10 Electrical Contractor based in Roseville, CA, we understand the intricacies of home remodeling across the Golden State. From the initial design concept to the final inspection, a well-planned schedule is your best defense against unexpected delays and cost overruns. This comprehensive guide will walk you through each phase of a typical bathroom renovation, highlighting key California-specific factors that can influence your project's duration and success.

Why a Realistic Timeline Is Crucial for California Homes

California's dynamic regulatory environment and high demand for quality construction services mean that renovation projects can sometimes take longer than anticipated in other states. A realistic timeline:

Phase 1: Planning and Design (4-8+ Weeks or More)

This initial phase is arguably the most critical for any successful renovation, especially in California. Skimping on planning here can lead to significant delays and complications later.

A. Budgeting and Financing

Before any design work begins, establish a realistic budget. California renovation costs are typically higher than the national average due to labor rates, material costs, and strict building codes. Consider not just materials and labor, but also permits, potential architectural fees, and a contingency fund (10-20% is recommended for California projects).

B. Design and Layout Selection

Work with a designer or your contractor to finalize your bathroom's layout, style, and functionality. This includes decisions on fixtures, finishes, lighting, and storage. Be mindful of California's Title 24 energy efficiency standards, which may influence lighting choices, and CALGreen residential mandatory measures, which focus on water efficiency and indoor air quality.

C. Material Sourcing and Lead Times

This is where many projects encounter their first delay. Custom cabinetry, unique tiles, or specialty fixtures can have lead times of several weeks or even months. Order materials early to ensure they are on-site when needed. Supply chain issues can still impact availability, so proactive sourcing is key.

D. Permits and Regulations: The California Factor

This is a major differentiator for a California bathroom renovation timeline. Most significant bathroom renovations require permits from your local building department. This includes structural changes, extensive plumbing, electrical work, and sometimes even just changing the layout. Powercore Inc, with CSLB #1134334 (General B) and #1098175 (C-10 Electrical), is well-versed in navigating California's permit processes. Key considerations include:

E. Hiring a Qualified Contractor

Finding a reputable, licensed contractor is paramount. Interview several, check references, review their portfolios, and verify their CSLB license status. Powercore Inc offers comprehensive remodeling services, ensuring all aspects of your project, especially the critical electrical and general construction components, are handled by certified professionals who understand California's specific requirements.

Phase 2: Demolition and Rough-Ins (1-3 Weeks)

Once permits are secured and materials are arriving, the physical work begins.

A. Demolition (2-5 Days)

This is often the quickest and messiest part. Existing fixtures, tiles, drywall, and flooring are removed. Proper containment and dust control are essential to protect the rest of your home.

B. Framing (if layout changes) (3-7 Days)

If your design includes moving walls, expanding the bathroom, or reconfiguring the shower area, new framing will be installed to support the updated layout.

C. Plumbing Rough-In (3-7 Days)

New water supply lines and drain/vent pipes are installed according to the new layout. This is crucial for future fixture placement and requires precision to meet code. Remember California's water efficiency standards when planning.

D. Electrical Rough-In (3-7 Days)

Wiring for new outlets, light fixtures, ventilation fans, and any specialty items (like heated floors or smart mirrors) is run. As a C-10 Electrical Contractor, Powercore Inc excels in ensuring your bathroom's electrical system is safe, up to code, and perfectly meets your design needs, including compliance with Title 24 for lighting controls and energy efficiency.

E. HVAC Rough-In (1-3 Days)

If a new or upgraded exhaust fan is needed, or if HVAC ductwork needs to be adjusted, this is done now. Proper ventilation is vital for moisture control and indoor air quality, a key component of CALGreen compliance.

F. Rough-In Inspections (1-3 Days + Wait Time)

Before walls are closed up, building inspectors will review the plumbing, electrical, and framing work. Scheduling these inspections can add a few days or even a week to your timeline, depending on your local building department's availability. This is a mandatory step in California.

Phase 3: Finishing Work (3-6+ Weeks)

This is where your bathroom starts to take shape, but it's also where details and material curing times can extend the schedule.

A. Drywall and Painting (1-2 Weeks)

New drywall is installed, taped, mudded, sanded, and primed. This is followed by painting the walls and ceiling. Allow adequate drying time between coats.

B. Flooring Installation (3-7 Days)

Tile, vinyl, or other flooring materials are installed. If using tile, this includes preparation, setting, and then waiting for grout to cure before heavy traffic.

C. Cabinetry and Vanity Installation (2-4 Days)

Once flooring is down, the vanity and any storage cabinets are installed.

D. Countertop Installation (1-3 Days)

If your vanity includes a separate countertop, it's installed after the cabinetry. Fabrication and templating often occur earlier in the project, but the actual installation is quick.

E. Tile Work (Showers, Backsplashes) (1-2 Weeks)

Installation of tile in the shower, on walls, or as a backsplash. This is labor-intensive and requires meticulous attention to detail. Grout also needs time to cure and seal.

F. Fixture Installation (3-5 Days)

Toilets, sinks, faucets, and showerheads are installed and hooked up. Ensure all selected fixtures comply with California's low-flow requirements.

G. Lighting and Electrical Trim (2-3 Days)

Switches, outlets, and light fixtures (including exhaust fans) are installed. Powercore Inc ensures all electrical components are safely and efficiently integrated, meeting all California electrical codes and design specifications.

H. Glass Shower Enclosures (1-2 Days Installation)

After tiling is complete, measurements are taken for custom glass shower doors or panels. Fabrication can take 1-3 weeks, so this often occurs late in the project timeline, with installation being relatively quick once the glass arrives.

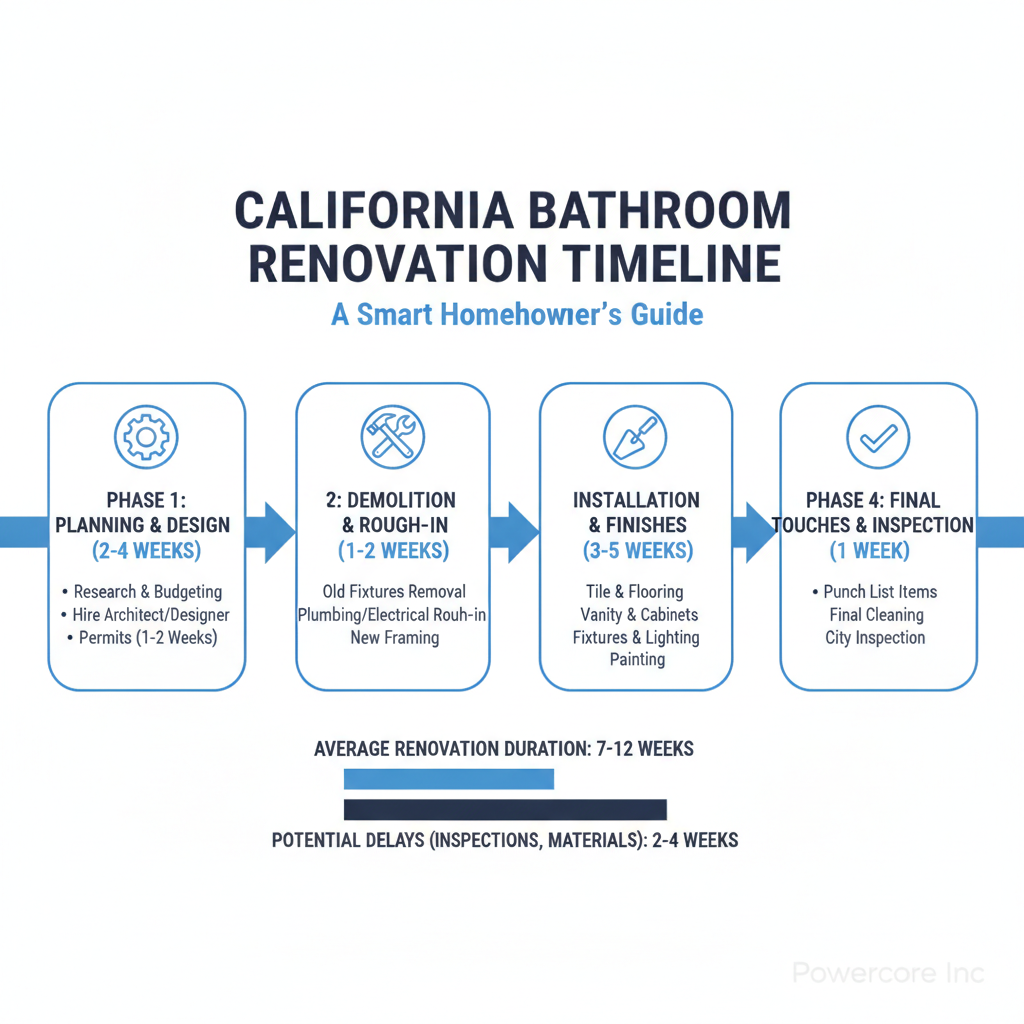

Infographic - Data visualization for this article
Infographic by Powercore Inc

Phase 4: Final Touches and Walkthrough (3-7 Days)

The finish line is in sight!

A. Cleaning (1-2 Days)

A thorough cleaning to remove construction dust and debris, preparing the space for use.

B. Punch List (1-3 Days)

A final walk-through with your contractor to identify any last-minute adjustments, touch-ups, or minor fixes. These items should be addressed promptly.

C. Final Inspections (1-2 Days + Wait Time)

Your local building department will conduct a final inspection to ensure all work meets code requirements. This is the last critical step to close out your permits. Again, factor in scheduling delays.

D. Decorating (Ongoing)

Add your personal touches with towels, art, and accessories to complete your new oasis.

Factors That Influence Your California Bathroom Renovation Timeline

While the above provides a general framework, several elements can significantly alter your project's duration:

Tips for a Smoother and More Efficient Renovation

Your California Bathroom Renovation Partner

Understanding the California bathroom renovation timeline is the first step towards a successful project. While it can seem daunting, with careful planning and the right partner, your dream bathroom is within reach. Powercore Inc is your trusted General B and C-10 Electrical Contractor, ready to guide you through every phase of your remodeling journey across California.

From navigating complex permitting processes to executing high-quality electrical and general construction work, our team ensures your renovation is completed efficiently, to code, and to your utmost satisfaction. Don't let the complexities of a California renovation deter you. Contact Powercore Inc today to discuss your bathroom remodeling vision and get a realistic project timeline. Call us at 916-699-8778 for a consultation and let's bring your dream bathroom to life.
